Tecnico Corporation was recognized in the FY26 PIA Bi-Weekly Newsletter (Issue #04, Dec. 1, 2025) for supporting PM11 (Berthing Rehab) as the embedded repair activity—providing training, constructive feedback, and team support to keep habitability remodeling on schedule.
Availability Highlights
Availability Started, Paychecks Authorized
The availability has officially started, calling SA00 on 20 November. With the CR approved, federal employees have begun receiving back pay ahead of the holiday season. However, current funding authorization expires 31 January, without further congressional action. The first nuclear milestone, PW15 was called 6 days late but with minimal downstream impact.
Topside

Work is continuing on the 5AC foundation, following a pause. The brig void structural repair has been scoped and the PSM team is awaiting direction to begin repairs. The tank preservation progresses with 52 of the 55 tanks now open, 2 in paint, 7 paint complete, 4 in blast, and 9 blast complete. All 14 access cuts have been completed. On the flight deck, NNS is cleaning 2CAT with blasting and UTs to follow and the 1JBD containment is installed. AIT work continues aggressively, progressing NTCDL and SSEE INC F alterations and commencing work on Simulation-at-Sea.
Propulsion Plant
In the propulsion plants, the ME team completed casing and rotor removals on 1 and 4MEs, nozzle plate removals and inspections are up next. The 3E/4E outage for breaker inspections and ship alteration were completed, while the 4EDG exciter cabinet re-assembly is ongoing, as the critical path to PW07. Inspections, preservation, and repairs continued on DUs, with 2DU hydro and I-beam repairs. Condenser cleaning finished on 1CTG but continues on 1 & 2 MEs, following diver evolution for hull valve inspection. ECIs continue on 1 & 2 CTGs and 4ME. Tube removal is underway on 2RB. Slip ring work for 6CMG finished with zero discrepancies and class B overhauls on two 2CH valves were completed. The RPFW condenser cleaning string has started in 1 plant. Honeycomb removal and external UTs have been completed on PZR heaters and heater removals have commenced. The nuclear production and engineering teams, with support from NNSY, continue planning for CP repairs.
Critical Paths
Production Completion Date (PW00)
- #2 Reboiler Tube Bundle Replacement
Combat Support Systems Available and Testing Ready to Start (SI00)
- Island and Mast Scaffolding > NTCDL install
Crew Move Aboard/Habitability (HB00)
- Rx Berthing 3-225-0-L Remodel > ENGR & Rx Move Aboard
Spotlight – Habitability
Habitability remodeling operations are advancing significantly in multiple compartments. Current work encompasses four berthing spaces, six sanitary facilities, two offices, and one passageway, all properly tagged out with active remodeling in progress. To enhance crew communication, a sanitary space status tracker has been installed near the Incident Command Post in HB2, providing real-time updates on facility availability.
PM11 (Berthing Rehab) is progressing work to maintain the remodel schedule at an enthusiastic pace. Recent accomplishments include, rack and vanity lighting disconnected in four berthings and complete rack and locker removal in one berthing with a second removal in progress. The Berthing Rehab team is focused on completing the eight total berthings undergoing rehab, on time. TECNICO CORP serves as the embedded repair activity supporting PM11 operations. The contractor continues to provide comprehensive training, delivers constructive feedback, and supports the team development throughout the berthing remodel process.
and vanity lighting disconnected in four berthings and complete rack and locker removal in one berthing with a second removal in progress. The Berthing Rehab team is focused on completing the eight total berthings undergoing rehab, on time. TECNICO CORP serves as the embedded repair activity supporting PM11 operations. The contractor continues to provide comprehensive training, delivers constructive feedback, and supports the team development throughout the berthing remodel process.

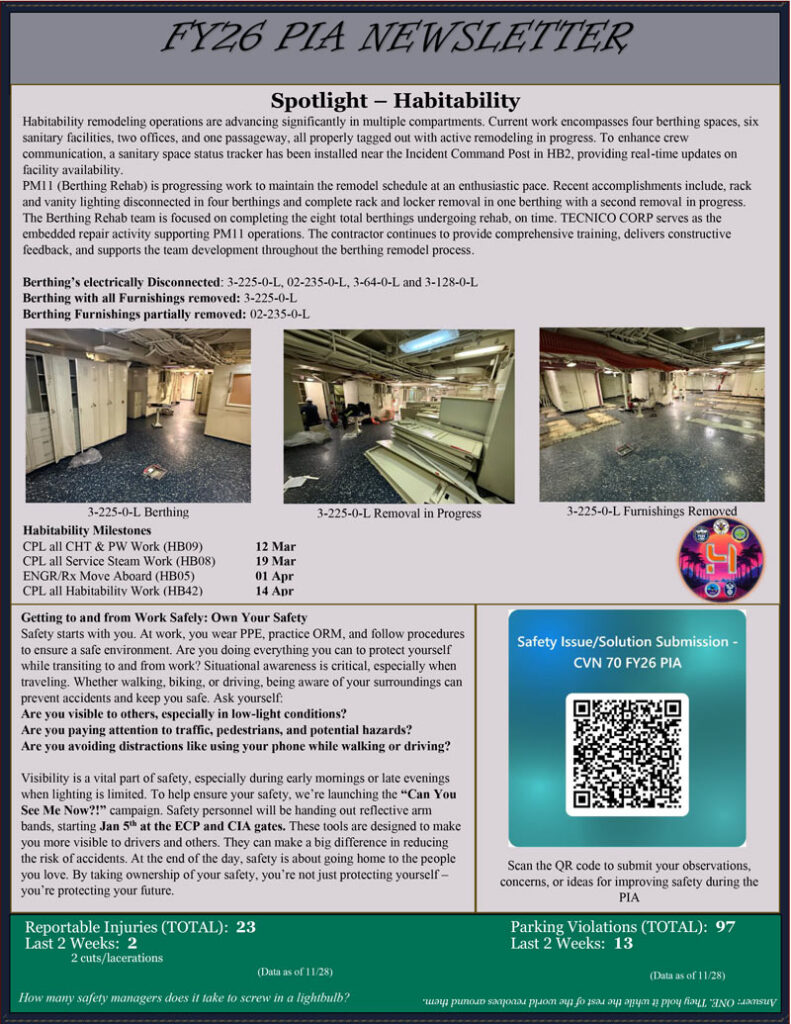

Berthing’s electrically Disconnected: 3-225-0-L, 02-235-0-L, 3-64-0-L and 3-128-0-L
Berthing with all Furnishing removed: 3-225-0-L
Berthing Furnishing partially removed: 02-235-0-L
Habitability Milestones
CPL all CHT & PW Work (HB09) 12 Mar
CPL all Service Steam Work (HB08) 19 Mar
ENGR/Rx Move Aboard (HB05) 01 Apr
CPL all Habitability Work (HB42) 14 Apr
Getting to and from Work Safely: Own Your Safety
Safety starts with you. At work, you wear PPE, practice ORM, and follow procedures to ensure a safe environment. Are you doing everything you can to protect yourself while transiting to and from work? Situational awareness is critical, especially when traveling. Whether walking, biking, or driving, being aware of your surroundings can prevent accidents and keep you safe. Ask yourself:
- Are you visible to others, especially in low-light conditions?
- Are you paying attention to traffic, pedestrians, and potential hazards?
- Are you avoiding distractions like using your phone while walking or driving?
Visibility is a vital part of safety, especially during early mornings or late evenings when lighting is limited. To help ensure your safety, we’re launching the “Can You See Me Now?!” campaign. Safety personnel will be handing out reflective arm bands, starting Jan 5th at the ECP and CIA gates. These tools are designed to make you more visible to drivers and others. They can make a big difference in reducing the risk of accidents. At the end of the day, safety is about going home to the people you love. By taking ownership of your safety, you’re not just protecting yourself – you’re protecting your future.
